Warehouse Management — Working Paper · Version 1.0

    One Object, One State, One Location: The Transition Ledger at the Centre of a Warehouse Management System

    Architecture, Computational Methods, and Field Evidence from MileSoft Warehouse Management

    MileSoft Engineering Research Group · August 2026 · 7 min read

    6 weeks → 8 daysnew-client onboarding, attributed to this module
    zone-rack-bintyped location records with capacity and current stock
    99%+inventory accuracy claimed on the product page

    Abstract

    Overview

    A warehouse management system is usually sold as a collection of workflows — receiving, putaway, picking, packing, shipping, counting. That framing obscures what the software actually is. Underneath every one of those workflows is a single ledger asserting, for each physical object, exactly one current state and exactly one current location, and every workflow is a guarded transition on that pair.

    This paper presents the architecture and computational methods of MileSoft Warehouse Management from that position. We state the two-coordinate invariant and the four obligations a transition must satisfy to preserve it, and show that the master data layer — item, location, vendor and user records — is not administrative overhead but the precondition that makes a transition validatable at all. A location carries a type and a capacity, so a putaway is feasible only where the unit's state and the location's type agree and the capacity is not exceeded.

    Three computational results follow. Directed putaway is a constrained assignment problem whose objective is travel-weighted velocity slotting, and permitting an ad-hoc override is a deliberate trade of slotting quality for receiving throughput that can be priced rather than merely allowed. Exception-triggered cycle counting is characterised by a coverage rate and an expected record staleness, which is the quantity a continuous count controls and a periodic count does not. And integration effort scales with the number of client mappings against a stable contract rather than with the number of custom pipelines, which is the mechanism behind the published onboarding result.

    A multi-client third-party logistics deployment reported new-client onboarding falling from six weeks to eight days, and that figure is attributed in its own source to this module's interface architecture. The same deployment's inventory-accuracy and dock-idle improvements are attributed to other modules and are not claimed here.

    Keywords

    Warehouse management systemWMS softwareDirected putawaySlotting optimizationCycle countingInventory accuracyMulti-client 3PL warehouseREST API warehouse integrationZone rack bin location masterWave planning and pickingBarcode and RFID warehouseDistribution centre operations

    Contributions

    What this paper covers

    Each contribution is designed to be independently useful to engineers, procurement teams, and platform evaluators.

    01

    The two-coordinate invariant, and the four obligations a transition owes it

    Every physical object carries exactly one state and exactly one location, and a warehouse management system is correct when every physical movement writes exactly one transition and no transition is written without a movement. Stating the invariant makes the failure modes of a warehouse enumerable rather than anecdotal.

    02

    Master data as the precondition for validation, not as administration

    A transition can be checked only against governed records: an item that exists, a location with a type and a capacity, a vendor a discrepancy can be attributed to, a user permitted to perform the movement. A location record carrying type and capacity turns putaway from a suggestion into a feasibility constraint.

    03

    Ad-hoc putaway priced rather than merely permitted

    Directed putaway is a constrained assignment problem; allowing an operator to override it during a receiving surge trades slotting quality for throughput. The trade is legitimate and should be measured, so the paper gives the objective it degrades and the rate at which override frequency erodes it.

    04

    Continuous counting characterised by staleness, not by frequency

    An exception-triggered cycle count controls expected record staleness — how long a wrong record survives before it is found. That is the quantity accuracy depends on, and it is the quantity a scheduled annual freeze cannot control at all.

    05

    Capability reference framework

    An eight-dimension, vendor-independent benchmark for warehouse management systems, each dimension answerable by demonstration on a live floor rather than by reading a specification.

    Standards

    Governing standards addressed

    Computational methods and workflows in this paper are grounded in and validated against these published standards.

    ISO/IEC 19987:2024

    Information technology — EPC Information Services (EPCIS) Standard

    The event model a transition ledger conforms to: what object, when, where, and under which business step.

    ISO/IEC 19988:2024

    Information technology — GS1 Core Business Vocabulary (CBV)

    Business step and disposition values, so receiving at one site is the same recorded fact as receiving at another.

    GS1 General Specifications

    GS1 identification keys and barcode symbology

    Item and location identifiers, symbology selection and print quality for a scan-driven floor.

    GS1 SSCC

    Serial Shipping Container Code

    Instance identity for a logistic unit, which is what allows two identical pallets to be tracked separately.

    ISO/IEC 15459-1:2014

    Information technology — Unique identification — Part 1: Individual transport units

    Unique identification of transport units outside a GS1 key scheme.

    ISO 22400-2:2014

    Key performance indicators for manufacturing operations management — Part 2

    The discipline of publishing a denominator with every accuracy and utilisation ratio.

    IEC 62264-3

    Enterprise-control system integration — Part 3: Activity models of manufacturing operations management

    Inventory operations as a defined activity with a specified interface to the enterprise system of record.

    ISO 28000:2022

    Security and resilience — Security management systems for the supply chain

    Role-based access and custody obligations across a multi-client facility.

    Full paper

    Read the complete text

    The entire paper is published here in full — sections, equations, figures, tables, and appendices.

    1Introduction

    Every distribution-centre operator eventually meets the ceiling. A system that was adequate for one client and eighty thousand square feet begins to crack at three clients and two hundred thousand. Onboarding takes six weeks. Custom workflows accumulate. The day the operations team starts saying they will do something in a spreadsheet until the software can be changed, the warehouse management system has become the bottleneck it was bought to remove.

    That is the product's own diagnosis and it is a good one. What this paper adds is a way to say precisely what such a system is, so that a buyer can test whether a candidate is the calm spine of a facility or the next ceiling.

    The definition offered here is narrow on purpose. A warehouse management system is a ledger asserting, for each physical object, one current state and one current location. Everything else it does — receiving, putaway, wave planning, picking, packing, dispatch, counting — is a guarded transition on that pair. Sections 3 and 4 develop the consequences.

    1.1Why the workflow framing misleads

    Software in this category is compared feature by feature: does it do wave picking, does it do cluster picking, does it handle hazmat. Those comparisons rarely predict which system a facility will end up routing around, because every serious candidate has the features.

    What separates them is whether the ledger stays true. A system permitting a movement it cannot record, or recording a movement that did not happen, degrades until its numbers are advisory — and a facility with advisory numbers reverts to physical verification, which is what the spreadsheet actually is.

    A warehouse routes around its system when the system's answer stops being worth checking. That is a property of the invariant, not of the feature list.

    1.2Contributions

    1. The two-coordinate invariant and the four obligations a transition must satisfy to preserve it (Sections 3.1 and 4.1).
    2. Master data stated as the precondition for validation, with location type and capacity as hard feasibility constraints on putaway (Sections 3.2 and 4.2).
    3. Directed putaway as a constrained assignment problem, and the cost of an ad-hoc override expressed in the objective it degrades (Section 4.2).
    4. Exception-triggered cycle counting characterised by coverage rate and expected record staleness (Section 4.3).
    5. Integration effort as mappings against a stable contract rather than per-client pipelines, which is the mechanism behind the published onboarding result (Sections 4.4 and 5.2).
    6. An eight-dimension capability reference framework for warehouse management systems (Section 6.3).

    2Background and Related Work

    Warehouse operations have an unusually good quantitative literature and an unusually poor connection between it and the software that runs them. The results below are settled; what is rarely stated is which of them a given system is actually implementing.

    2.1Travel is the cost, and slotting is the lever

    De Koster, Le-Duc and Roodbergen's review of order-picking establishes the finding every design in this field rests on: travel dominates picking time. Picking itself is fast; walking between pick faces is not.

    Two families of response follow. Routing policies decide the sequence in which a picker visits faces — Roodbergen and de Koster on aisle routing, Petersen's comparison of routing policies in a conventional warehouse — and slotting policies decide which face a unit occupies in the first place. Slotting is the more durable lever because it changes the distance every subsequent pick must travel.

    Gu, Goetschalckx and McGinnis survey the design decisions this implies at facility level. Their contribution for present purposes is the ordering: layout constrains slotting, slotting constrains routing, and a routing improvement inside a bad slotting is bounded by the slotting.

    2.2Class-based storage and where its assumptions bind

    Class-based storage descends from Dickie's value classification but substitutes movement for value: fast movers occupy faces near the depot, slow movers occupy the back. Its efficiency gain over random storage is well established and its assumption is easy to miss — it requires demand to be stable enough that yesterday's velocity predicts tomorrow's travel.

    This is why the product's material treats slotting analytics as continuous rather than annual. A class assignment computed once a year is a prediction with a one-year horizon, and the literature's efficiency results assume a horizon over which the classification holds.

    Continuous re-slotting is not a convenience feature. It is what keeps the assumption behind class-based storage true for long enough to deliver the result the literature promises.

    2.3Identity, events and the boundary above

    A transition ledger needs identifiers it can bind to. GS1 supplies the Global Trade Item Number for a trade item class and the Serial Shipping Container Code for an individual logistic unit; ISO/IEC 15459-1 covers transport units outside that scheme; the General Specifications govern symbology and print quality, which decide whether a scan succeeds at the first attempt on a cold aisle.

    The event model is EPCIS, standardised as ISO/IEC 19987, with its vocabulary in ISO/IEC 19988. A transition is an event with a business step and a disposition, which is what allows a warehouse ledger to be a traceability record rather than a private log.

    IEC 62264-3 places inventory operations as a defined activity with a specified interface to the enterprise system of record. The practical consequence, and the one Section 4.4 develops, is that the interface is the product boundary: a system whose workflows are reachable only through its own screens has no boundary, and every integration becomes bespoke.

    3System Overview

    The system is organised as a governed master-data layer, a transition ledger over it, and a set of task generators — putaway, wave, pick, dispatch, count — that propose transitions the ledger then guards. The captured deployment presents these as tabs: master data, identifier management, inbound, planning, picking, dispatch, reports and traceability.

    Warehouse management dashboard with tabs for dashboard, master data, barcode and QR, inbound, bill of materials and production planning, picking, dispatch, reports and traceability. Six tiles read: raw materials 2,097 items in stock, semi-finished goods 924, finished goods 685, production today 64 items produced, pending dispatch 68 orders ready, and active users 17 currently online. A quick-actions panel offers generate barcode, put away and pick items. A recent-activities list records a semi-finished unit put away in location A1-R2-B3, a production order completed, a finished-goods barcode generated and a dispatch order picked.

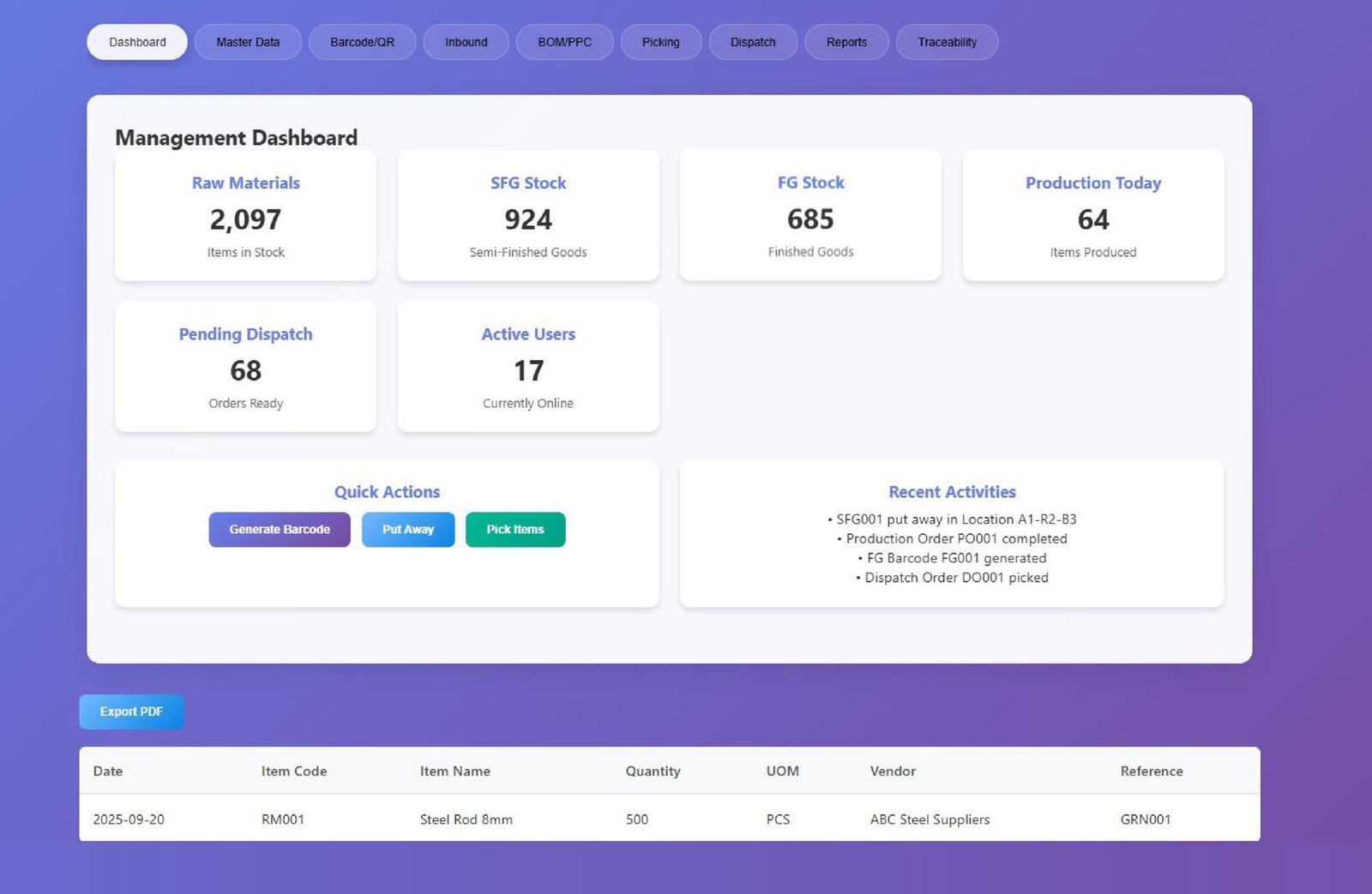

    Figure 1. Product capture: the management dashboard. Stock is reported as three separate positions — raw material, semi-finished and finished goods — beside production completed today, orders ready for dispatch and users currently online, with quick actions for identifier generation, putaway and picking, and a recent-activity list in which each entry names a transition and the location it touched.

    3.1The two coordinates

    Every tracked object carries a state and a location. In the captured build the states are raw material, semi-finished and finished goods, and the location is a code composed from zone, rack and bin.

    It is worth being explicit that this build spans production. A pure distribution warehouse has one stock state and many locations; this one has three states, a production-planning tab and a traceability tab, because material is transformed inside the facility rather than only moved through it. The state coordinate is doing real work here rather than being a formality.

    Table 1. The transitions the system generates, and what each changes. Every row alters exactly one coordinate or both, and none alters neither.
    TransitionStateLocation
    Goods receiptunset to raw materialunset to receiving area
    Putawayunchangedreceiving area to a typed storage location
    Issue to productionunchangedstorage to line side
    Production completionraw to semi-finished, or semi-finished to finishedline side to a location of the matching type
    Pickunchangedstorage to staging
    Dispatchfinished goods to shippedstaging to outbound
    Cycle countunchangedunchanged — it writes an observation, and an adjustment only on variance

    The last row is what distinguishes a ledger from a database. A count is an observation about the ledger, not an instruction to it; the adjustment it may cause is a separate, attributable transition.

    3.2Four masters, and what each makes checkable

    Master data is presented in the captured build as four registers — users, locations, items and vendors — and each exists to make a different part of a transition validatable.

    Table 2. The four master registers and the transition obligation each supports.
    RegisterWhat it holdsWhat it makes checkable
    Item masteritem type, unit of measure, minimum stock, current stockThat the thing being moved is a thing the system knows, in units it can add up
    Location masterzone, rack, bin, location type, capacity, current stockThat the destination exists, accepts this state, and has room
    Vendor mastersupplier records with contact details and statusThat a receiving discrepancy can be attributed rather than merely counted
    User masterrole-based accounts by employee and departmentThat the person performing the movement is permitted to perform it

    The location register carries the most weight in Section 4.2, because it holds two fields that turn putaway from advice into arithmetic: a type, so a semi-finished unit cannot be stored where the facility has designated something else, and a capacity against current stock, so a suggested destination can be full.

    Master data management screen with tabs for users, locations, items and vendors, showing the location master. Input fields accept zone, rack, bin and location type. A table row lists location code A1-R2-B3 with zone A1, rack R2, bin B3, type semi-finished goods store, capacity 100 and current stock 45, with actions to edit the record or generate a barcode for it.

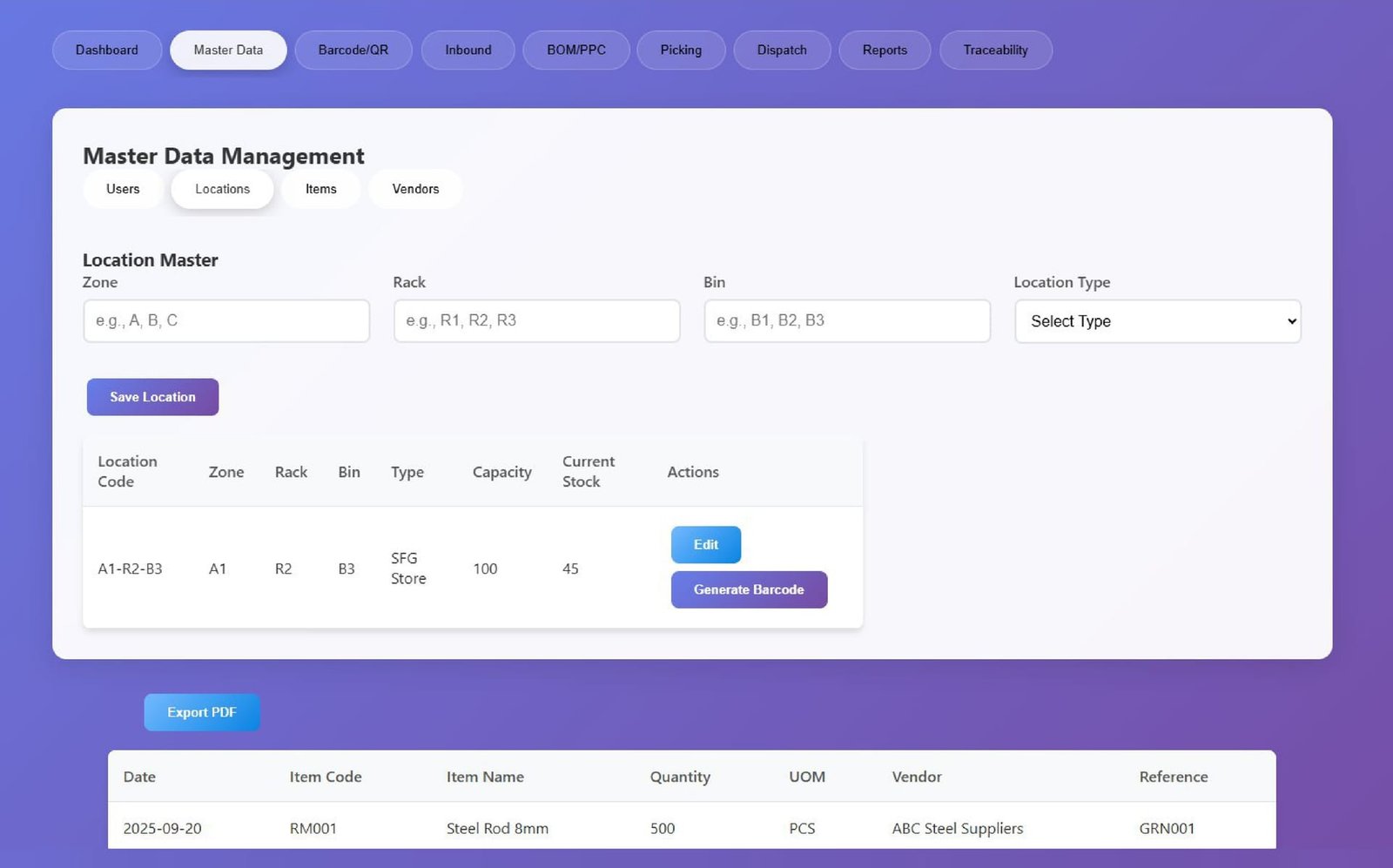

    Figure 2. Product capture: the location master. A location is composed from zone, rack and bin into a single code, carries a type and a capacity against its current stock, and can generate its own barcode — which is what allows a putaway to be confirmed against the shelf rather than against a screen.

    3.3Identifiers for both coordinates

    The system generates and prints identifiers for items and for locations. That both coordinates are independently scannable is the enabling condition for two-key confirmation: an operator scanning a unit and a shelf asserts two physical facts about each other rather than confirming a screen.

    The consequence for print quality is not decorative. Every guard in Section 4 assumes a scan succeeds first time; a label that has to be typed converts a validated transition into an asserted one, and the ledger's guarantees degrade to whatever the operator entered.

    4Computational Methods

    Four computations carry the system. The first is the invariant everything else must preserve; the other three are the decisions the system makes on top of it.

    4.1The invariant and its four obligations

    Let U be the set of tracked units, S the set of states and L the set of locations, with sigma and lambda the functions assigning a state and a location to each unit.

    every unit has exactly one state and exactly one location, and the volume assigned to any location must not exceed that location's capacity(invariant)
    v(u) is the unit's volume in the location's capacity units and kappa(l) the capacity carried on the location record. The second condition is what makes the location master an operational constraint rather than a description.

    Four obligations preserve this. Every physical movement writes exactly one transition; no transition is written without a movement; a transition is rejected unless it resolves against governed masters; and a transition that would violate the capacity or type condition is refused rather than recorded with a warning.

    Table 3. The failure modes of the invariant, what each looks like on the floor, and what a facility does in response. All four are common and only the first is usually noticed.
    Violated obligationWhat it looks likeFacility response
    Movement without transitionPicker cannot find stock the system showsPhysical search, then an adjustment nobody can attribute
    Transition without movementSystem shows stock in a location that is emptySame search, same adjustment, opposite sign
    Ungoverned resolutionFree-text location or item on a recordThe record cannot be validated or aggregated; it is excluded from reports
    Guard downgraded to warningOver-capacity or type-mismatched location acceptedStock stored where nobody looks for it; found at the next count

    The first two produce compensating errors that a net reconciliation cancels. A facility measuring only net variance can hold both faults indefinitely and conclude its records are sound.

    4.2Directed putaway, and the price of an override

    Directed putaway assigns an incoming unit to a location. The product's material names the rule inputs — velocity, size, weight, hazard class, refrigeration — and the literature of Section 2.1 supplies the objective they are serving.

    minimise the sum over units and locations of pick frequency times travel distance, subject to: each unit assigned exactly once, no location over capacity, and no assignment to a location whose type the unit's state does not permit(putaway)
    f(u) is the unit's expected pick frequency, d(l) the travel distance from the depot to location l, and tau(u,l) is 1 where the location type accepts the unit's state and 0 otherwise. The objective is travel-weighted velocity slotting: fast movers near, slow movers far.

    Ad-hoc putaway relaxes this. The operator is offered the system's suggestion and may confirm it or select an approved alternative, which the product's material recommends during receiving surges. The trade is real and worth stating as one: throughput now against travel cost on every subsequent pick of that unit.

    the cost of overriding is pick frequency times the extra distance, summed over the overridden units; mean cost per override is that total divided by their number(override)
    O is the set of overridden putaways in a period. The quantity is measurable from data the system already holds, because both the suggested and the chosen location are recorded.

    Two things follow. Overrides on fast movers cost far more than overrides on slow movers, because f(u) multiplies the penalty — so a surge policy that permits override on any unit is worse than one that permits it only below a velocity threshold. And because the system records what it suggested, override cost is reportable, which converts an operational habit into a number a manager can act on.

    Ask a candidate system whether it stores the location it suggested alongside the location that was used. Without both, the cost of every override is invisible and the slotting engine cannot be evaluated at all.

    4.3Cycle counting, characterised by staleness

    The product's material states that counts run continuously alongside picking, triggered by class, by time since last count and by picker discrepancy, without an operational freeze. What that controls is not the count rate but how long a wrong record survives.

    coverage rate c = counts performed / (locations x periods); expected staleness under scheduled counting is half the count interval; under exception triggering it is shortened by the discrepancy detection rate mu(staleness)
    Theta is the time between a record becoming wrong and the error being found. mu is the rate at which a picker encountering an unexpected quantity raises a count task — a second, demand-driven discovery channel that a scheduled count does not have.

    The mu term is where the design earns its keep, and it has a property worth naming: it is concentrated exactly where errors matter. A location nobody picks from contributes nothing to mu, and an error there costs nothing until it is counted. A fast-moving face is visited many times a period, so an error in it is found almost immediately.

    This also explains why an annual freeze count cannot control staleness however thoroughly it is performed. Its coverage rate is one per location per year, so expected staleness is six months, and the errors it finds are on average half a year old — long past the point where they could be attributed to a cause.

    Record accuracy — the share of locations whose count matches — is then the operational figure to manage, because it is the probability that any given pick finds what the system promised. The published deployment moved it from 91% to 99.4%, and that result is attributed in its own source to the tracking module rather than to this one; Section 5.3 says so.

    4.4Why an interface changes the shape of onboarding

    The published onboarding result — six weeks to eight days for a new client — is the strongest claim attached to this module, and its mechanism is simple enough to state as arithmetic.

    with per-client pipelines, effort is the sum of a fixed cost plus a bespoke build for each client; against a stable contract, it is one fixed cost plus a mapping per client(onboard)
    a is the fixed cost of the integration surface itself, b(k) the bespoke build for client k, and m(k) the mapping of client k's fields onto an existing contract. The claim is not that mapping is trivial but that it is bounded, because the target of the mapping does not move.

    The distinction that matters is stability rather than protocol. An interface exposed over a well-known transport but changing shape per client offers no reduction: each client still faces a bespoke build, and the fixed cost has merely been paid twice.

    The second half of the product's claim is configuration rather than integration — pick paths, putaway rules and packing flows configured rather than coded. That is the same argument applied inside the facility: a workflow change that requires a release is a bespoke build with a longer queue in front of it.

    The test is not whether an interface exists. It is whether the same endpoint served the last three clients unchanged.

    5Reported Outcomes and Field Evidence

    This module is unusual in this library in having one deployment result attributed to it specifically. That makes the separation between what belongs to it and what belongs to the programme around it more important, not less.

    5.1Observed properties of the software

    Table 4. Properties read directly from the delivered software, with where each was observed.
    PropertyValueWhere observed
    Stock states tracked separatelyraw material, semi-finished, finished goodsManagement dashboard
    Location code compositionzone, rack and bin into one codeLocation master
    Location typinga location carries a type, e.g. a semi-finished storeLocation master
    Location capacitycapacity against current stock, per locationLocation master
    Identifiers for both coordinatesbarcode generation for items and for locationsLocation master and identifier screens
    Master registersusers, locations, items, vendorsMaster data screen
    Activity record granularityeach entry names a transition and the location it touchedManagement dashboard

    One observation belongs here rather than in a footnote. The captured build is a manufacturing warehouse — three stock states, a production-planning tab, production orders completing on the activity list — while the product's written material describes a multi-client third-party logistics distribution centre. Both are true of the product; only the first is visible in these captures, and nothing about multi-client operation is demonstrated by them.

    5.2The result attributed to this module

    A multi-client third-party logistics operator deployed six MileSoft warehouse modules across a distribution centre. Its previous warehouse system had no interface, so every client integration required roughly six weeks of custom data plumbing. After deployment, new-client onboarding is reported at eight days.

    The published account attributes this specifically and mechanically: client integrations became interface connections with standard mappings rather than custom-coded pipelines. That is the mechanism Equation (onboard) states, and it is the reason this figure is reported here as belonging to this module while the deployment's other results are not.

    Attribution, stated plainly. The onboarding result is this module's. The accuracy improvement is attributed in the same source to the tracking module, and the dock-idle reduction to the dock and yard modules. None of those is claimed here.

    Two caveats belong with the figure even so. It is a single operator's experience with no sample of clients stated, and the six-week baseline is a property of the system replaced rather than of the category — an operator whose previous system already had a stable interface should expect a much smaller change.

    5.3The results that belong to the programme

    Table 5. The deployment's other reported outcomes and the module each is attributed to in its own source. None is claimed for this module.
    OutcomeValueAttributed to
    Inventory accuracy91% to 99.4%Inventory Tracking — handheld and RFID cycle counting
    Dock idle time38% reductionLoading Dock Management with Truck Turnaround
    Average truck dwell3 h 10 min to 1 h 20 minTruck Turnaround with Loading Dock Management

    The accuracy figure deserves a note because it is the one most easily misattributed. Section 4.3 explains why continuous counting controls staleness, and this module generates the tasks; but the published account credits the handheld and radio-frequency capture that made counting possible alongside picking. Both statements are consistent, and the honest reading is that the result required the pair.

    5.4Modelled labour recovery

    The published return model for this module is stated as labour recovered across receiving, picking, packing and shipping. Its assumptions are printed here so a reader can substitute their own.

    Table 6. Modelled scenario — not a deployment result. Assumptions are the published defaults of the return-on-investment model for this product.
    AssumptionValue
    Warehouse staff in scope15
    Labour gain attributed to the module15%
    Modelled recoverythe equivalent of 2.25 full-time staff
    Scope of the gainreceiving, picking, packing and shipping

    The 15% is an assumption and, unusually, one this paper can say something about. Section 2.1 records that travel dominates picking time, so a labour gain of this size is plausible only if it comes substantially from travel — which means it depends on the slotting quality of Section 4.2 rather than on the software being installed. A facility that deploys the system and overrides directed putaway routinely should not expect it.

    6Discussion

    6.1What the ceiling actually is

    The product's material locates the ceiling at three clients and two hundred thousand square feet. The floor area is a proxy; the binding variable is the number of distinct rule sets the facility must run at once.

    One client is one set of putaway rules, one pick path, one packing flow. Three clients sharing docks and aisles is not three times that — it is three rule sets plus the interactions between them, because a shared resource must be allocated under rules that differ by the client claiming it. A system where client is a filter rather than a first-class dimension expresses those interactions as exceptions, and exceptions accumulate until somebody opens a spreadsheet.

    This reframes the buying question. Not whether the system supports multiple clients, but whether client is a dimension of the allocation decision or a column on the report — and the way to find out is to ask for two clients with contradictory putaway rules competing for the same aisle.

    A facility does not outgrow a warehouse system's capacity. It outgrows the number of simultaneous rule sets the system can express without exceptions.

    6.2Two count regimes, and what each can control

    This library contains a paper on the annual physical count and this one on continuous counting, and they are not competitors. They control different things and a facility usually needs both.

    Table 7. What each counting regime controls. The distinction is staleness against completeness, and neither substitutes for the other.
    Continuous cycle countPeriodic full count
    Controlsexpected staleness of a wrong recordcompleteness of coverage at a point in time
    Coveragebiased toward what is pickedevery location, including those nobody visits
    Costabsorbed into normal operationsoperational shutdown
    Blind spotslow-moving and dormant stockeverything that happens between counts
    Evidence valueoperational — accuracy between countsstatutory — a position at a stated date

    The blind spots are complementary, which is the point. Continuous counting is driven by picking activity, so dormant stock is exactly what it does not reach; a periodic count reaches everything and says nothing about the eleven months either side of it.

    The practical consequence is that high record accuracy from continuous counting is not, on its own, an argument for abandoning the periodic count — it is an argument for being able to sample it. That transition is discussed in the companion paper on annual tagging and is gated on the accuracy figure being measured rather than asserted.

    6.3A capability reference framework for warehouse management systems

    Table 8. Capability reference framework. Each dimension separates a warehouse management system from an inventory database with screens, and each is answerable by demonstration on a live floor rather than by reading a specification.
    DimensionQuestion the system must answer by demonstration
    D1 Governed destinationsAttempt a putaway to a location that is not in the master. Is it accepted?
    D2 Capacity as a guardPut away into a location already at capacity. Refused, or warned and recorded?
    D3 Type as a guardStore a unit in a location typed for a different stock state. What happens?
    D4 Suggested against usedDoes the record keep both the location the system directed and the one chosen?
    D5 Override cost visibleCan the system report the travel cost of last month's ad-hoc putaways?
    D6 Count as observationDoes a count write an observation and a separate attributable adjustment, or overwrite the quantity?
    D7 Staleness reportedHow long, on average, does a wrong record survive before it is found?
    D8 Contract stabilityDid the same integration endpoint serve the last three clients unchanged?

    D4 is the cheapest and most revealing. A system that discards its own suggestion cannot be evaluated, improved, or held to account for the slotting it produced.

    6.4Generalisability

    The two-coordinate invariant generalises to any custody system where objects have a state and a place: tool cribs, evidence rooms, laboratory sample stores, container yards. The staleness characterisation of Section 4.3 generalises to every inspection regime where errors are discovered either on a schedule or on use, and the mu term is always concentrated on what is used.

    What does not generalise is the onboarding figure. Six weeks to eight days is a comparison against one specific replaced system, and the size of the improvement is a property of what was there before rather than of what replaced it.

    7Threats to Validity and Limitations

    1. The onboarding result is a single operator's experience. No number of clients onboarded, no complexity distribution and no definition of what onboarding includes is published, and the six-week baseline describes the system replaced rather than the category.
    2. The captures do not show multi-client operation. The build observed is a manufacturing warehouse with three stock states and production planning; nothing in these figures demonstrates client isolation, shared-dock allocation or per-client rule sets.
    3. The 99% accuracy claim on the product page has no baseline. The attributed 99.4% belongs to a deployment and to a different module; the two figures should not be read as one claim.
    4. The modelled 15% labour gain is an assumption. Section 5.4 argues it depends on slotting quality rather than on installation, which makes it a claim about how the system is operated.
    5. Slotting quality is not observable from a screenshot. The captures show that locations carry type and capacity; they do not show what the directed-putaway engine optimises or whether the objective of Equation (putaway) is the one implemented.
    6. The staleness model assumes independent errors. Where a single mis-scan corrupts a batch of adjacent locations, the discovery process is correlated and expected staleness is longer than Equation (staleness) suggests.
    7. Scan reliability is an unmeasured dependency. Every guard in Section 4.1 assumes the identifier scans; a degraded label converts a validated transition into a typed one with no change to the interface.
    8. Cycle counting reaches what is picked. Dormant stock accumulates error at the rate it always did, and the accuracy figure a continuous regime reports is weighted toward the locations it visits.

    The second limitation is the one to keep in view when reading this paper. The strongest published claim concerns multi-client operation and the strongest visual evidence concerns a manufacturing warehouse; they are different deployments, and this paper reports each only where its own source does.

    8Future Work

    • Publishing override cost. Both the suggested and the used location are recorded, so the travel penalty of Equation (override) is computable today; reporting it would let a facility set a surge policy on evidence rather than on instinct.
    • Staleness as a published metric. Reporting the mean interval between a record becoming wrong and being found would replace an accuracy percentage whose denominator is rarely stated.
    • Velocity-thresholded override. Permitting ad-hoc putaway only below a pick-frequency threshold would keep the receiving-surge benefit while removing the expensive tail of it.
    • An onboarding study with a distribution. Eight days from one operator is an anecdote; ten clients with their integration scope stated would be evidence, and the mechanism in Equation (onboard) predicts what the shape should look like.
    • Dormant-stock coverage. A count trigger driven by time since last observation, rather than by picking activity, would close the blind spot Section 6.2 identifies without reintroducing a freeze.

    9Conclusion

    A warehouse management system is a ledger asserting one state and one location for every object, and every workflow it offers is a guarded transition on that pair. Stating it that narrowly makes the system testable: the four obligations of Section 4.1 are things a buyer can attempt to violate on a live floor in an afternoon.

    Three results follow. A location record carrying a type and a capacity turns putaway into a feasibility problem rather than a suggestion, which is what allows the guard to refuse rather than warn. Permitting an ad-hoc override is a defensible trade whose price is computable from data the system already stores — and it is far more expensive on fast movers than on slow ones. And continuous counting controls expected staleness rather than count frequency, with its discovery rate concentrated exactly where errors are costly, which is the property no periodic count can reproduce.

    The published onboarding result belongs to this module and its mechanism is arithmetic: mappings against a contract that does not move, rather than a build per client. The same deployment's accuracy and dock results belong to other modules, and this paper has left them there.

    The framework of Section 6.3 is offered as the durable contribution. Its fourth dimension costs nothing to check and settles more than the rest: ask whether the system still knows where it told the operator to put the pallet.


    Appendix ANomenclature

    Table 9. Symbols and abbreviations used in this paper.
    Symbol / termMeaning
    U, S, LThe sets of tracked units, stock states and locations
    sigma(u), lambda(u)The state and the location assigned to unit u
    v(u)Volume of unit u, in the capacity units of a location
    kappa(l)Capacity carried on location l's master record
    tau(u,l)1 where location l's type accepts unit u's state, 0 otherwise
    f(u)Expected pick frequency of unit u
    d(l)Travel distance from the depot to location l
    x(u,l)Assignment variable: 1 where unit u is stored at location l
    OThe set of putaways overridden by an operator in a period
    Delta CTotal travel cost of those overrides
    cCount coverage rate — counts per location per period
    muRate at which picking activity raises a discrepancy count task
    ThetaRecord staleness — time from a record becoming wrong to it being found
    a, b(k), m(k)Fixed integration cost, bespoke build for client k, mapping for client k
    RM / SFG / FGRaw material, semi-finished goods, finished goods
    GRNGoods receipt note — the document a receiving transition resolves against

    Appendix BWorked Numerical Examples

    Appendix B.1What one week of ad-hoc putaway costs

    A receiving surge produces 120 overridden putaways in a week. 18 of them are fast movers with an expected pick frequency of 40 picks per month; the remaining 102 are slow movers at 1.5 picks per month. In each case the chosen location is on average 22 metres further from the depot than the directed one.

    Applying Equation (override) over a month: the fast movers contribute 18 x 40 x 22 = 15,840 metres of additional travel; the slow movers contribute 102 x 1.5 x 22 = 3,366. The total is 19,206 metres a month, and the mean cost per override is 160 metres.

    The distribution is the finding. Fifteen per cent of the overrides generate eighty-two per cent of the cost. A policy permitting override only above a slow-moving threshold would keep 102 of the 120 overrides — almost all the receiving-surge relief — while removing four fifths of the penalty.

    Both distances are in the record, because the system stores what it suggested. Without that field this calculation is impossible and the surge policy is set by argument.

    Appendix B.2Two counting regimes on the same warehouse

    A facility has 4,000 locations. Under an annual freeze count, coverage is one per location per year.

    Applying Equation (staleness): c = 1 per location-year, so expected staleness is 0.5 years — about six months. An error introduced in March is found, on average, in September, by which time the shift, the operator and the movement that caused it are unrecoverable.

    Now run continuous counting at 60 count tasks per working day over 250 days: c = 15,000 / 4,000 = 3.75 per location-year, giving 0.133 years — about seven weeks — from scheduled counting alone. Add picker-triggered discovery on the fast-moving third of locations at mu = 20 per location-year, and staleness on those falls to 1 / (2 x 3.75 + 20) = 0.036 years, or under two weeks.

    The asymmetry is the design working as intended. Errors in locations that are picked from constantly are found in days; errors in locations nobody touches persist — and cost nothing until somebody does touch them. What the regime cannot do is find the dormant error before the periodic count, which is why Section 6.2 keeps both.

    Appendix B.3Where the onboarding saving actually comes from

    An operator onboards four clients a year. Under per-client pipelines each takes 30 working days, of which roughly 6 are scoping common to any approach and 24 are the bespoke build.

    Applying Equation (onboard): pipeline effort is 4 x 30 = 120 days a year. Against a stable contract with a one-off interface cost of 40 days already paid, a mapping takes 6 days of scoping plus 2 of field mapping, so 4 x 8 = 32 days a year.

    Two readings follow. The steady-state saving is 88 days a year, and the interface pays for itself inside the first six clients. And the published eight-day figure is consistent with this shape — it is the mapping term, not the whole engagement, which is worth knowing before quoting it to a client.

    Provenance

    Where these numbers come from

    Every quantitative claim in this paper traces to a named deployment, a product specification, or an explicitly labelled model.

    MetricReported valueProvenance
    New client onboarding time8 days (from 6 weeks)Operator-reported — Tier 1 Manufacturers (3PL, Madhya Pradesh, India)/case-studies/warehouse

    REST APIs replaced per-client custom data pipelines.

    Location record granularity in the location masterzone-rack-bin code, typed, with capacity and current stockProduct specification/products/wms

    Read from the location master captured on the product page; each location can also generate its own barcode.

    Stock states tracked as separate positions on the management dashboardraw material, semi-finished, finished goodsProduct specification/products/wms

    Read from the management dashboard captured on the product page; the build shown is a manufacturing warehouse spanning production, not a pure distribution deployment.

    Inventory accuracy the product page claims99% or betterProduct specification/products/wms

    A product-page benefit claim without a baseline or sample; the case-study figure of 99.4% is a separate, attributed measurement.

    Labour hours recovered across receiving, picking, packing and shipping15% of 15 staff (modelled)Modelled estimate
    • 15 warehouse staff in scope
    • 15% labour gain attributed to the module
    • Model and defaults published in src/data/roiModels.ts
    Inventory accuracy99.4% (from 91%)Operator-reported — Tier 1 Manufacturers (3PL, Madhya Pradesh, India)/case-studies/warehouse

    Continuous exception-triggered cycle counting replaced scheduled freeze counts.

    Dock idle time38% reductionOperator-reported — Tier 1 Manufacturers (3PL, Madhya Pradesh, India)/case-studies/warehouse

    Bibliography

    References

    1. [1]de Koster, R., Le-Duc, T., and Roodbergen, K. J. (2007). Design and control of warehouse order picking: A literature review. European Journal of Operational Research, 182(2), 481-501.
    2. [2]Roodbergen, K. J., and de Koster, R. (2001). Routing methods for warehouses with multiple cross aisles. International Journal of Production Research, 39(9), 1865-1883.
    3. [3]Petersen, C. G. (1997). An evaluation of order picking routeing policies. International Journal of Operations & Production Management, 17(11), 1098-1111.
    4. [4]Gu, J., Goetschalckx, M., and McGinnis, L. F. (2007). Research on warehouse operation: A comprehensive review. European Journal of Operational Research, 177(1), 1-21.
    5. [5]H. F. Dickie (1951). ABC Inventory Analysis Shoots for Dollars, Not Pennies. Factory Management and Maintenance, vol. 109, no. 7, July 1951, pp. 92-94; the origin of ABC classification, applying Pareto and Lorenz to stock value.
    6. [6]Little, J. D. C. (1961). A proof for the queuing formula: L = lambda W. Operations Research, 9(3), 383-387.
    7. [7]F. W. Harris (1913). How Many Parts to Make at Once. Factory, The Magazine of Management, vol. 10, no. 2, pp. 135-136, 152; the first statement of the economic order quantity, reprinted in Operations Research 38(6), 1990, pp. 947-950. https://pubsonline.informs.org/doi/10.1287/opre.38.6.947
    8. [8]International Organization for Standardization / International Electrotechnical Commission (2024). ISO/IEC 19987: Information technology - EPC Information Services (EPCIS) Standard, version 2.0. ISO/IEC, Geneva. https://www.iso.org/standard/85557.html
    9. [9]International Organization for Standardization / International Electrotechnical Commission (2024). ISO/IEC 19988:2024 - Information technology - GS1 Core Business Vocabulary (CBV). ISO/IEC, Geneva, edition 3, March 2024; publishes GS1 CBV 2.0, ratified June 2022, which fixes the vocabularies for the EPCIS business step, disposition and business transaction type fields. https://www.iso.org/standard/85558.html
    10. [10]GS1 (2024). GS1 General Specifications. GS1 AISBL; defines the GTIN, SSCC and GLN identification keys. https://ref.gs1.org/standards/genspecs/
    11. [11]GS1 (2024). Serial Shipping Container Code (SSCC). GS1 identification key series; an 18-digit key for a logistic unit, carried under application identifier 00. https://www.gs1.org/standards/id-keys/sscc
    12. [12]GS1 (2023). GS1 Logistic Label Guideline. GS1 AISBL; the SSCC is the only mandatory field on a GS1 logistic label. https://www.gs1.org/standards/gs1-logistic-label-guideline/1-3
    13. [13]International Organization for Standardization / International Electrotechnical Commission (2014). ISO/IEC 15459-1: Information technology - Automatic identification and data capture techniques - Unique identification - Part 1: Individual transport units. ISO/IEC, Geneva. https://www.iso.org/standard/54779.html
    14. [14]International Organization for Standardization (2014). ISO 22400-1: Automation systems and integration - Key performance indicators (KPIs) for manufacturing operations management - Part 1: Overview, concepts and terminology. ISO, Geneva. https://www.iso.org/standard/56847.html
    15. [15]International Organization for Standardization (2014). ISO 22400-2: Automation systems and integration - Key performance indicators (KPIs) for manufacturing operations management - Part 2: Definitions and descriptions. ISO, Geneva; defines OEE as availability x effectiveness x quality ratio. https://www.iso.org/standard/54497.html
    16. [16]International Electrotechnical Commission / International Society of Automation (2025). Enterprise-control system integration - Part 1: Models and terminology. IEC 62264-1; ANSI/ISA-95.00.01-2025 (IEC 62264-1 Mod).
    17. [17]International Society of Automation (2013). Enterprise-control system integration - Part 3: Activity models of manufacturing operations management. ANSI/ISA-95.00.03-2013 (IEC 62264-3 Modified).
    18. [18]International Organization for Standardization (2022). ISO 28000: Security and resilience - Security management systems - Requirements. ISO, Geneva; published 15 March 2022. https://www.iso.org/standard/79612.html
    19. [19]International Organization for Standardization (2023). ISO 5725-1: Accuracy (trueness and precision) of measurement methods and results - Part 1: General principles and definitions. ISO, Geneva (superseding ISO 5725-1:1994).
    20. [20]Kagermann, H., Wahlster, W., and Helbig, J. (2013). Securing the future of German manufacturing industry: Recommendations for implementing the strategic initiative INDUSTRIE 4.0. Final report of the Industrie 4.0 Working Group, acatech - National Academy of Science and Engineering. https://www.acatech.de/wp-content/uploads/2018/03/Final_report__Industrie_4.0_accessible.pdf

    FAQ

    Frequently asked questions

    Common questions from engineers and technical evaluators about this research.

    Free Download

    Take the paper with you

    The typeset PDF carries the same text, equations, figures, and full bibliography — formatted for circulation, tender packs, and offline review.

    Citation

    Cite this paper

    MileSoft Engineering Research Group (2026). One Object, One State, One Location: The Transition Ledger at the Centre of a Warehouse Management System: Architecture, Computational Methods, and Field Evidence from MileSoft Warehouse Management. Working Paper Version 1.0. MileSoft Software Technologies. https://milesoft.net/research/products/wms

    Ready to Transform Your Operations?

    Let's discuss how our industrial solutions can optimize your processes, reduce costs, and drive measurable growth.
